Skip to Content

3 Quick Commissioning Checks for Deye All-in-One Installs

Written by Kushan Thirunavukkarasu (Technical Account Manager & Deye In house Specialist | AC Solar Warehouse)
13 July 2026 by
3 Quick Commissioning Checks for Deye All-in-One Installs
AC Solar Warehouse Pty Ltd, Eloisa Sparano

Deye All-in-One systems are designed to make solar battery installations simpler by combining the inverter, battery stack and gateway functions into one integrated system.

But as with any hybrid inverter and battery installation, a good result depends on good commissioning.

In a recent webinar training session, we covered three first install checks that can prevent confusion on site. These are not product faults, they are simple setup checks that help confirm the inverter is receiving the right information from the meter, CTs and Wi-Fi logger before the installer leaves.

Getting this right can help avoid unnecessary support calls, incorrect monitoring data and return visits.

So, before you pack up, check these three things.

1. Meter address

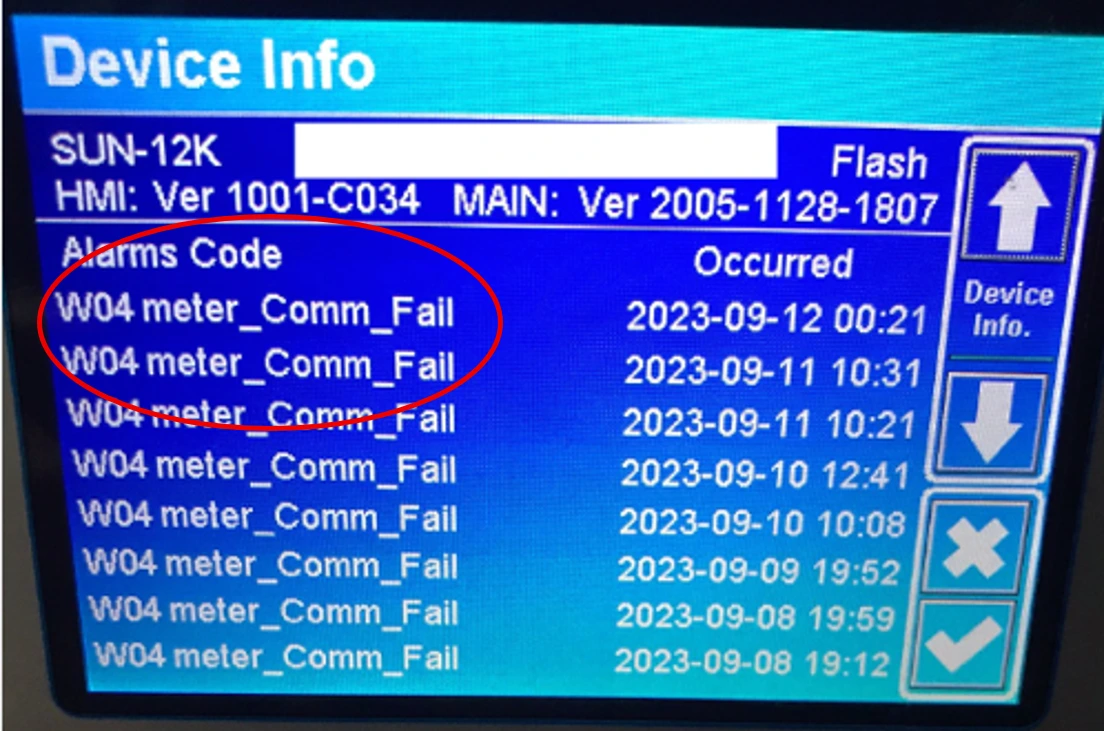

If two meters are assigned the same address, the inverter may receive conflicting data. This can lead to a W04 warning, or incorrect energy readings as shown below.

The Answer:

  • Meter 1 = 001
  • Meter 2 = 002

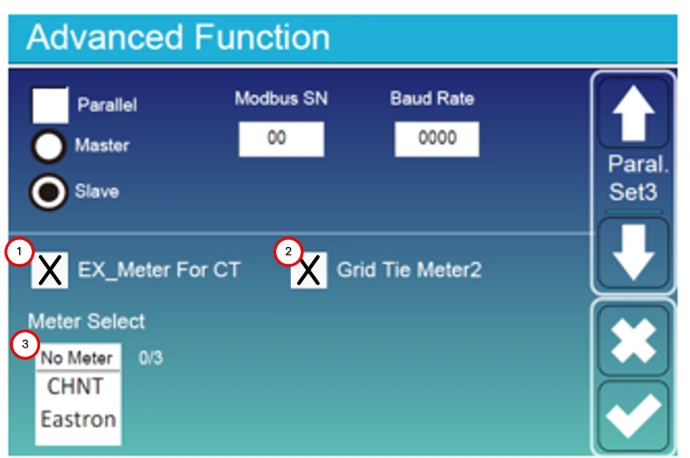

To set this up

1.     Enable Ex_Meter For CT

2.     Enable Gri d Tie Meter2

3.     Under “Meter Select” Confirm Meter 2 = 002

4.     Then connect Meter 1

5.     Under “Meter Select” Confirm Meter 1 = 001, Meter 2 = 002



2. CT direction

CT direction is one of the easiest things to miss.

If the CT is facing the wrong way, the inverter may read import as export, or export as import. The system may be operating normally, but the data will look wrong.

That is when the customer may later say the app does not match what is happening on site.

The answer:

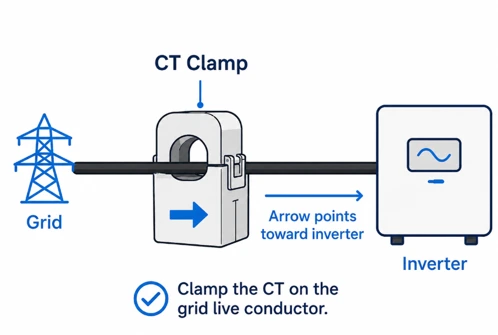

  • The CT arrow should point toward the inverter
  • The load reading should always be positive
  • A known load should be turned on to confirm the reading makes sense

Quick check:

1.     Arrow toward inverter

2.     Known load test completed

3.     Import/export readings make sense


3. Wi-Fi band

The Wi-Fi logger requires a 2.4 GHz network. Many modern routers combine 2.4 GHz and 5 GHz under one network name, which can cause connection issues.

Check before leaving site:

  • 2.4 GHz Wi-Fi is enabled
  • Logger is connected to the 2.4 GHz network
  • Band steering is disabled if required on the router
  • Logger is showing online

This simple step can prevent one of the most common monitoring-related support calls.

Final takeaway

Most first-install callbacks are not caused by product failure. They are usually caused by small commissioning checks that were missed before handover.

Before leaving site, check:

  • Meter address
  • CT direction
  • Wi-Fi band.
